Why Airlines Are Turning to ACMI in 2026: How Engine Groundings and Delivery Delays Are Driving the Capacity Crisis

Share
Why Airlines Are Turning to ACMI in 2026: How Engine Groundings and Delivery Delays Are Driving the Capacity Crisis
Photo by Ramon Kagie / Unsplash

Airlines in 2026 are facing a perfect storm of operational challenges. Pratt & Whitney's GTF engine issues have grounded hundreds of aircraft worldwide, forcing carriers to scramble for solutions. At the same time, aircraft delivery delays have left airlines unable to grow their fleets as planned.

ACMI leasing has become the go-to solution for airlines struggling with GTF groundings and capacity shortages, with wet lease costs ranging from $4,000 to $6,000 per block hour for narrow-body aircraft. When your planes are stuck on the ground waiting for engine inspections or repairs, you need flying aircraft immediately. ACMI providers offer complete packages including the aircraft, crew, maintenance, and insurance, letting you maintain your schedule without the long-term commitment of purchasing new planes.

The impact goes beyond just a few carriers. Spirit Airlines expects GTF-related aircraft on ground events to continue through at least 2026, even after receiving over $150 million in compensation. Airlines like airBaltic report the situation is finally stabilizing, but the damage to capacity and revenue has already been done. Your ability to meet passenger demand depends on finding creative solutions to keep your network operating.

Key Takeaways

  • GTF engine issues have grounded hundreds of aircraft and forced airlines to seek immediate capacity solutions through wet leasing
  • ACMI leasing costs between $4,000 and $6,000 per block hour but provides airlines with operational flexibility during engine groundings and delivery delays
  • Engine inspection requirements are expected to continue affecting airline operations through 2026, making short-term capacity solutions essential for maintaining schedules

Origins of the Capacity Crunch: GTF Engine Groundings

The 2026 aviation capacity crisis stems from widespread failures in Pratt & Whitney's PW1000G engine family, particularly affecting the PW1100G variant that powers the Airbus A320neo family. Over 835 aircraft sit grounded globally due to contaminated powder metal in high-pressure turbine components, forcing airlines into emergency fleet adjustments.

Scale and Timeline of Aircraft Groundings

More than 835 A320neo family aircraft remain grounded as of April 2026. This represents 38% of the global GTF-powered fleet.

The groundings accelerated throughout 2025 and into early 2026. Approximately 3,000 engines require inspection or refurbishment. Pratt & Whitney, owned by RTX, aims to resolve most issues by late 2026, though industry observers remain skeptical of this timeline.

The crisis forces airlines to pull aircraft from service for extended shop visits. Some carriers won't see their planes return until 2027. You're watching the largest fleet grounding event since the 737 MAX crisis, but this one affects multiple airlines simultaneously across different regions.

The Powder Metal Contamination Crisis Explained

Contaminated powder metal in the high-pressure turbine section caused the crisis. The defective material came from a supplier and affects critical engine components that operate under extreme temperatures and stress.

When the contaminated powder metal degrades, it can lead to premature wear and potential engine failure. This creates serious safety concerns that required immediate action from regulators and manufacturers.

Pratt & Whitney must inspect engines earlier than planned maintenance cycles. Many engines need complete refurbishment or component replacement. The repair process takes months per engine, and MTU Aero Engines and other partners face severe capacity constraints in their maintenance facilities.

Airlines and Aircraft Most Affected

Spirit Airlines faces the most severe impact with 39 of its 91 A320neo family jets grounded as of mid-2025. This crippled the carrier's bankruptcy recovery efforts.

Wizz Air reported 37 aircraft grounded as of May 2025, with disruptions continuing through 2027. The budget carrier depends heavily on A321neo aircraft for its growth strategy.

Other heavily affected operators include:

  • airBaltic - significant portion of A220 fleet affected (A220 uses PW1500G variant)
  • Volaris - multiple groundings forcing route cancellations
  • JetBlue - four A321neos sidelined
  • Delta - four A321neos grounded

These airlines share a common problem: they built their fleet strategies around fuel-efficient GTF-powered aircraft. Now they're scrambling for replacement capacity while watching competitors with CFM-powered A320neos operate normally.

How Engine Shortages Disrupted Airline Operations

Engine shortages created severe operational problems for airlines in 2026, forcing them to ground aircraft and reduce capacity. Maintenance backlogs increased sharply while engine reliability issues cut into profitable routes.

Maintenance and MRO Backlog Escalates

Your airline faces engine shop turnaround times that have increased by 35% for older engines and over 150% for newer models. MRO facilities cannot keep up with demand as more engines require unscheduled shop visits.

The PW1100G-JM engine issue caused the biggest disruption. Contaminated powder metal in critical parts forced 600-700 engines into early inspections and repairs. Your maintenance teams struggle to find available shop slots as capacity remains constrained.

Parts shortages make the problem worse. You cannot complete engine overhauls on schedule because suppliers face their own backlogs. Major MRO providers report they are booked months in advance, leaving you with limited options when engines fail.

Impacts on Airline Scheduling and Route Reductions

You have grounded aircraft sitting on the tarmac waiting for engines. Over 835 A320neo aircraft remained grounded in 2026, representing 38% of the global fleet for that aircraft type.

Route reductions became necessary as your available capacity shrank. You cannot meet passenger demand when significant portions of your fleet stay on the ground. Some airlines cut unprofitable routes entirely while others reduced flight frequency on key routes.

Aircraft orders do not help your immediate problem. Delivery delays mean you cannot replace grounded planes with new ones. Your fleet planning becomes unpredictable when you do not know if engines will arrive on time.

Time on Wing and Engine Reliability Challenges

Time on wing for engines dropped significantly below expectations. Engines that should run for thousands of hours now require earlier shop visits. This hurts your operations because you planned maintenance schedules around longer intervals.

Engine reliability issues compound your scheduling difficulties. You cannot predict when an engine will need removal, making it harder to plan maintenance windows. Unscheduled removals disrupt your flight schedule and require expensive last-minute solutions.

The promised 15% fuel savings from new engines remain out of reach while aircraft stay grounded. You lose both the environmental benefits and cost savings that justified your aircraft orders.

Aircraft Delivery Delays and the Ripple Effect on Fleets

Aircraft manufacturers are struggling to meet delivery schedules, creating a shortage that affects your airline's ability to grow and modernize. Production bottlenecks at Airbus and engine supply issues with Pratt & Whitney have left airlines waiting years for new aircraft while operating older, less efficient planes.

Airbus, Pratt & Whitney, and the Slowed Production Ramp-Up

Airbus has faced significant challenges ramping up production to meet pre-pandemic targets. The manufacturer's CEO Guillaume Faury acknowledged that supply chain constraints continue to limit output across all programs. Engine deliveries have become a major bottleneck for your new aircraft.

Pratt & Whitney's GTF engine issues have compounded these problems. The GTF recall forced hundreds of aircraft out of service for inspections and repairs. RTX, Pratt & Whitney's parent company, has struggled to produce enough replacement engines while simultaneously addressing quality control problems.

CFM International's LEAP-1A engines also face production delays. While CFM has fewer quality issues than Pratt & Whitney, the manufacturer cannot produce engines fast enough to meet Airbus's assembly rate targets. This means your A320neo deliveries may arrive months or even years behind schedule.

Backlog of Aircraft Orders and Deliveries

The current backlog represents over 5,000 aircraft that should have been delivered by now. Airlines planned their growth strategies around specific delivery dates that no longer hold true. You might have scheduled new routes or planned to retire older aircraft based on deliveries that never arrived.

This backlog will likely persist through 2030 based on current production rates. Your airline faces tough choices about whether to wait for delayed aircraft or seek alternative solutions. Some carriers have had to cancel planned route expansions or reduce flight frequencies.

Airbus A220 and A320neo Family Implications

The A220 program has experienced its own delivery challenges despite being designed for efficiency. Pratt & Whitney GTF engines power all A220 variants, making this aircraft type particularly vulnerable to the engine shortage. Your A220 deliveries face dual pressures from both airframe production issues and engine availability.

The A320neo family depends heavily on engine supply from either Pratt & Whitney or CFM International. With both engine manufacturers constrained, you cannot simply switch engine types to get your aircraft faster. The A320neo backlog alone represents several years of production at current rates, leaving you with limited options for fleet renewal.

ACMI and Wet Leasing: The Airline Response to Unprecedented Disruption

Airlines are using wet-lease solutions at record levels in 2026 to bridge capacity gaps created by GTF groundings and aircraft delivery delays. ACMI contracts now provide the fastest path to operational aircraft when purchasing or standard leasing cannot meet urgent timeline requirements.

Why Wet-Lease and ACMI Solutions Are on the Rise

The wet-lease market has grown significantly because airlines face problems from multiple directions at once. GTF engine inspections have grounded hundreds of A320neo family aircraft, while Boeing and Airbus continue to miss delivery targets by months or even years.

When your airline needs capacity immediately, ACMI leasing gives you a complete operational package. You get the aircraft, crew, maintenance, and insurance all from one provider. The lessor operates the flights under their air operator certificate while you maintain commercial control, set ticket prices, and manage customer relationships.

Low-cost carriers have become major users of ACMI services in 2026. These airlines typically operate lean fleets, so even a few grounded aircraft create serious schedule disruptions. Wet-lease agreements let you maintain service levels without canceling flights or disappointing passengers.

The delivery delay crisis has pushed airlines toward ACMI even for planned expansion. If you ordered new aircraft expecting delivery in early 2026 but now face a late 2026 or 2027 timeline, wet leasing fills that gap.

Practicalities of ACMI for Fleet Management in 2026

Your ACMI provider delivers a fully operational aircraft with trained crew ready to fly your routes. Payment works on an hours-operated basis, which means you pay only for actual flight time rather than fixed monthly rates.

Common ACMI aircraft types in 2026:

  • 737-800: Widely available for immediate deployment
  • A320ceo: Mature platform with strong crew availability
  • 737 MAX: Limited ACMI availability due to delivery constraints
  • A320neo: Some availability from specialized lessors

Most ACMI contracts in 2026 run between three months and two years. Short-term agreements help you cover peak summer demand or replace grounded aircraft during engine inspections. Longer contracts work better when you face extended delivery delays.

Your operations team needs minimal preparation time. The lessor handles crew training, maintenance scheduling, and insurance compliance. You provide route assignments, coordinate with your ground handling teams, and integrate the aircraft into your network.

Several specialized airlines dominate the ACMI market in 2026. These providers maintain dedicated fleets specifically for wet-lease operations rather than running scheduled passenger services.

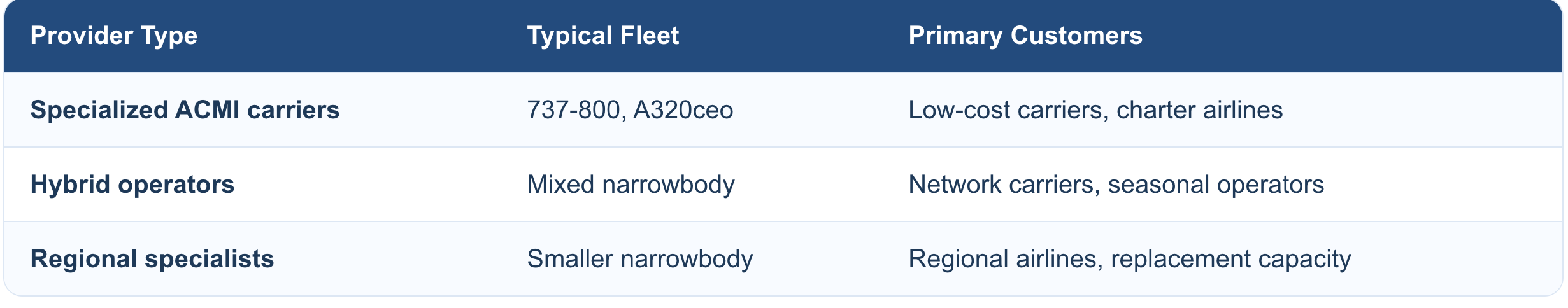

Major ACMI providers by fleet type:

Your choice of provider depends on your specific needs. Established ACMI specialists typically offer better pricing and faster deployment because they maintain standby capacity. Some network carriers also provide ACMI services using their own surplus aircraft, though availability varies by season.

Demand has pushed lead times longer in 2026. You might wait 30-60 days for aircraft availability compared to 7-14 days in previous years. Early contract negotiations give you better aircraft selection and crew quality.

Cost Analysis and Contract Considerations

ACMI pricing in 2026 ranges from $3,500 to $7,000 per block hour for narrowbody aircraft. Your actual rate depends on contract length, aircraft type, utilization patterns, and current market conditions.

You pay for block hours, which include taxi time and flight time. Additional costs include fuel, airport fees, navigation charges, and ground handling. The lessor covers crew salaries, training, maintenance, and insurance within the hourly rate.

Key contract terms to negotiate:

  • Minimum monthly hours: Affects your flexibility and unit costs
  • Cancellation terms: Important if your grounded aircraft return early
  • Crew bases: Impacts positioning costs and schedule efficiency
  • Maintenance reserves: Some contracts include buffers for unexpected work

Short-term ACMI costs more per hour than owning aircraft, but you avoid capital expenditure and long-term commitments. When GTF engines require inspection, wet leasing costs less than canceling flights and rebooking passengers.

You should compare ACMI rates against your fully loaded operating costs. Include crew training, maintenance overhead, insurance, and capital costs in your analysis. Many airlines find ACMI economical for temporary capacity needs despite higher hourly rates.

Financial and Strategic Ramifications for Airlines

The GTF engine crisis and delivery delays are forcing airlines to make difficult financial decisions while manufacturers face pressure to compensate carriers. Some airlines are filing for bankruptcy protection, while others are negotiating support packages and rethinking how they plan their fleets.

Chapter 11 Filings and Airline Restructuring

Spirit Airlines filed for Chapter 11 bankruptcy protection in late 2024, becoming one of the most visible casualties of the capacity shortage. The ultra-low-cost carrier was hit particularly hard because it operated a young fleet of GTF-powered aircraft that became grounded just as the airline needed them most.

The engine groundings created an AOG (aircraft on ground) crisis that Spirit couldn't overcome. When you're running a low-cost model with thin profit margins, even a small number of grounded planes can destroy your economics. Spirit had dozens of aircraft sitting idle while still making lease payments.

Other airlines with heavy GTF exposure are watching their cash reserves carefully. You might see additional restructurings in 2026 if the groundings persist longer than expected. Airlines that were already struggling financially before the engine crisis now face an existential threat.

Manufacturer Compensation and Support

Pratt & Whitney has been providing compensation to airlines affected by the powdered metal defect, but the support varies widely. According to Aviation Week, some carriers have negotiated cash payments while others receive lease credits or extended warranties.

You should know that manufacturer support typically doesn't cover all your losses. The compensation might cover direct costs like lease payments on grounded aircraft, but it rarely accounts for lost revenue or the higher costs of wet-leasing replacement capacity. Large airlines with more negotiating power tend to secure better deals than smaller carriers.

The support packages also include access to spare engines as Pratt & Whitney increases its shop capacity. Over 150 GTF-powered aircraft are expected to return to service in 2026, which should ease some pressure.

Fleet Planning Strategies Amid Engine Shortfalls

You need to rethink your fleet planning when you can't rely on scheduled deliveries or consistent engine availability. Airlines are now building more buffer capacity into their plans instead of running tight fleets. This means higher costs but less vulnerability to disruptions.

Cirium data shows that airlines are diversifying their engine orders when possible. If you're ordering new aircraft, you might specify CFM engines instead of GTFs, even if it means longer delivery times. Some carriers are also keeping older, less efficient aircraft in service longer than planned because they need the capacity.

Key planning adjustments include:

  • Extending lease terms on existing aircraft
  • Acquiring used aircraft as bridge capacity
  • Increasing reliance on ACMI providers for flexibility
  • Building larger spare engine pools

Your capital expenditure plans need more flexibility too. Fixed fleet plans that looked smart two years ago now create operational nightmares when aircraft don't arrive or engines fail unexpectedly.

Looking Forward: Engine Upgrades, Durability Improvements, and Market Adjustments

Pratt & Whitney is rolling out significant technological upgrades to address GTF engine durability issues, with the Hot Section Plus program beginning in 2026 and the GTF Advantage entering service. These improvements will increase maintenance intervals and reduce groundings, though shop capacity constraints will continue challenging airlines as they navigate fleet planning in the coming years.

Technological Advances: GTF Advantage and Hot Section Plus

Pratt & Whitney introduced two major upgrade paths for the PW1100G-JM engines that power your A320neo aircraft. The GTF Advantage received FAA certification in February 2025 and will enter service in 2026 with improved thrust and durability.

For existing engines, the Hot Section Plus (HS+) upgrade offers a more immediate solution. This retrofit package includes approximately 35 new part numbers that can be installed during planned maintenance visits starting in 2026. The changes reduce oxidation and wear in the engine's hot section, delivering 90-95% of the durability improvements expected from the full GTF Advantage engine.

According to Pratt & Whitney's vice president of sales and marketing Nick Tomassetti, HS+ brings the durability improvements of the GTF Advantage hot section to today's GTF engines. The upgrade will nearly double time on wing compared to current configurations. This represents a significant improvement for your fleet planning, as longer intervals between shop visits mean fewer aircraft out of service at any given time.

Outlook for Engine Maintenance and Shop Capacity

Engine shop capacity remains a bottleneck even as these upgrades roll out. You'll face continued pressure on maintenance slots through 2026 and beyond as operators rush to retrofit their fleets with HS+ improvements.

The timing of these upgrades coincides with ongoing GTF inspections and part recalls that have already strained the maintenance network. Pratt & Whitney, working with partners like MTU and IAE, must balance processing engines for mandated inspections while incorporating the new upgrade packages.

Your maintenance planning should account for extended lead times at authorized shops. The addition of 35 new part numbers in the HS+ package requires supply chain coordination that may initially slow turnaround times before efficiency improves.

ACMI providers will likely maintain their elevated role in your network planning through 2027. Even as engine upgrades reduce groundings, delivery delays from Airbus mean you won't see immediate relief in aircraft availability.

The capacity crunch has permanently shifted how you approach fleet flexibility. Airlines are building longer-term ACMI contracts rather than viewing wet leases as purely seasonal solutions. This gives you protection against future disruptions while OEMs work through their backlogs.

Your aircraft sourcing strategy should now include scenario planning for various upgrade adoption rates among your fleet. Earlier adoption of HS+ improvements will reduce your reliance on external capacity faster, but requires coordination with maintenance providers and capital allocation for the retrofit packages.

Frequently Asked Questions

Airlines face complex decisions when managing fleet capacity during engine groundings and delivery delays. Understanding ACMI leasing structures, regulatory requirements, and operator selection helps carriers navigate the current capacity crisis.

What is ACMI leasing, and how does it differ from wet lease, dry lease, and charter operations?

ACMI leasing provides you with an aircraft, crew, maintenance, and insurance as a complete package. The term ACMI is interchangeable with wet leasing in the aviation industry.

Under an ACMI arrangement, you retain commercial control of the flights while the lessor handles all operational aspects. You provide fuel, pay airport fees, and manage the route network and pricing.

A dry lease gives you only the aircraft without crew or maintenance support. You need your own pilots, cabin crew, and maintenance personnel to operate under your air operator certificate.

Charter operations differ because the charter company maintains both operational and commercial control. You purchase seats or the entire aircraft for specific flights rather than integrating the capacity into your own route network.

Why are airlines increasing ACMI usage in 2026 to manage short-term capacity shortages?

ACMI costs between $4,000 and $6,000 per block hour for a 737-800 or A320 in 2026. This approach lets you adjust capacity based on demand without long-term capital investment.

You can activate ACMI resources rapidly during operational disruptions. This flexibility matters when you face aircraft groundings, crew shortages, or other unexpected challenges.

The strategy has shifted from a last-resort solution to a core fleet planning tool. You can maintain your flight schedules and protect market share while addressing underlying fleet issues.

Peak season demand and new route launches benefit from ACMI arrangements. You avoid the financial commitment of purchasing or long-term leasing when you only need temporary capacity increases.

How are GTF engine inspections and groundings affecting airline schedules and fleet availability?

Pratt & Whitney GTF engine groundings forced many airlines to seek ACMI capacity starting in 2024. The inspections require removing engines from service for extended periods.

Your airline faces reduced fleet availability when GTF-equipped aircraft sit on the ground. The grounding affects A320neo and A220 family aircraft that use these engines.

You need backup capacity to maintain your published schedules during these groundings. ACMI providers fill the gap while your aircraft undergo mandatory inspections and repairs.

The scale of GTF issues drove significant growth in European ACMI operator fleets. Supply chain problems with engine parts extended the duration of groundings beyond initial estimates.

What aircraft delivery delays are driving the current capacity crunch, and which fleets are most impacted?

Aircraft manufacturers face massive production backlogs that push deliveries months or years behind schedule. You cannot receive new aircraft when promised, creating immediate capacity gaps.

Boeing and Airbus struggle with supply chain disruptions that slow production rates. Your planned fleet expansion gets delayed even when you placed orders years in advance.

Scheduled maintenance can sideline your aircraft for weeks or months. When combined with delivery delays, you lose capacity from both ends of your fleet planning.

Narrowbody aircraft like the 737 MAX and A320neo family experience the most significant delivery delays. These aircraft types form the backbone of short and medium-haul operations for most carriers.

What are the regulatory and operational requirements for airlines using ACMI providers on international routes?

You maintain commercial control under ACMI arrangements, but the lessor operates under their own air operator certificate. This structure requires coordination between regulatory authorities.

Your ACMI provider must hold appropriate certifications for the routes and regions where they operate. International flights need approval from aviation authorities in multiple countries.

You remain responsible for passenger handling, ticketing, and customer service. The ACMI operator handles flight operations, crew scheduling, and aircraft maintenance under their certificate.

Bilateral air service agreements between countries may restrict which operators can fly certain routes. You need to verify that your ACMI provider has the necessary traffic rights and permissions.

Which ACMI operators are most commonly used in Europe and globally, and how do airlines evaluate them?

European ACMI operators expanded their fleets significantly during the post-COVID recovery period. These providers became essential partners when GTF groundings and delivery delays accelerated.

You evaluate ACMI operators based on aircraft availability, crew qualifications, and maintenance standards. The provider's safety record and regulatory compliance history matter for your brand reputation.

Fleet composition affects which ACMI provider you choose. You want aircraft types that match your existing fleet or meet specific route requirements.

Response times and contractual flexibility influence your selection process. You need providers who can deploy aircraft quickly and adjust terms as your capacity needs change.
